Skip to Content
Transformer Selection Guide

How to Choose the Right Transformer

Picking the right transformer comes down to your voltage, load, installation site, and project goals.

Use this guide to compare oil-immersed and dry-type, lock in the key specs, and skip the mistakes that delay commissioning before you send out your RFQ.

30+ Years Manufacturing
Delivered to 60+ Countries
24h Engineering Reply
Table of Contents

Everything You'll Find in This Guide

14 sections breaking down transformer selection from spec confirmation to RFQ prep. Skip ahead to what you need, or read it top to bottom in about 12 minutes.

12 minute read
14 sections
Engineer-reviewed
01 / Type

Oil-Immersed vs Dry-Type Transformer

Before you lock in voltage, capacity, or certifications, the first call is which type fits your project.

Most industrial, commercial, and utility installations come down to one of these two. Each is built for different environments, fire codes, load profiles, and maintenance setups.

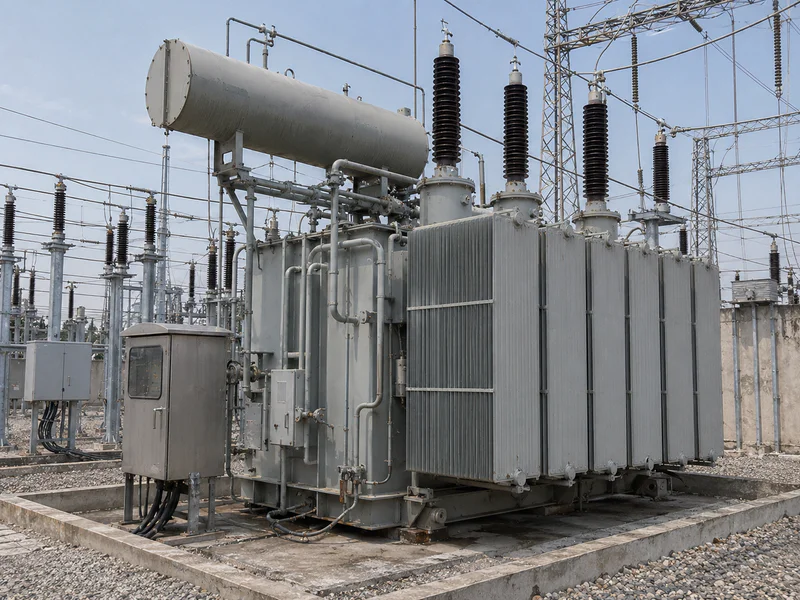

Outdoor oil-immersed power transformer installed at industrial substation Outdoor · Utility

Oil-Immersed Transformer

Mineral or ester oil cools the windings. Higher capacity ceiling, stronger overload tolerance, and the proven choice when the unit sits outdoors or in a dedicated transformer room.

Choose This If You Need

  • Outdoor installation
  • Large capacity (MVA-scale)
  • Better cost efficiency per MVA
  • Utility, industrial, or mining operation
  • Harsh or remote environments
Quote an Oil-Immersed Unit
Cast-resin dry-type transformer in a modern indoor electrical room Indoor · Commercial

Dry-Type Transformer

Air or cast resin handles cooling. No oil means no leakage, lower fire risk, and quieter operation. Built for indoor electrical rooms and occupied buildings.

Choose This If You Need

  • Indoor installation
  • Better fire safety
  • Lower routine maintenance
  • Low-noise operation
  • Commercial or occupied buildings
Quote a Dry-Type Unit

Need to compare 16 spec points side-by-side before you decide?

See Full Comparison Table
Detailed Comparison

Compare by Topic

Switch tabs to focus on what matters for your project. Cooling first, then site, then safety, then cost.

Side-by-side comparison of oil-immersed and dry-type transformers grouped into four categories: cooling, installation, safety, and cost.
Comparison Item Oil-Immersed Dry-Type
Cooling Method Mineral oil or ester oil circulation Air cooling or resin insulation
Cooling Efficiency Higher efficiency for large-capacity operation Suitable for moderate indoor loads
Voltage Class Widely used for medium and high-voltage systems Mostly low and medium-voltage systems
Capacity Range Medium to large capacities Small to medium capacities

Once you've picked a type, the next step is matching it to your application — utility, factory, hospital, data center, or solar plant.

Explore by Application
02 / Application

Choose by Application

Different projects need different transformer designs.

Your installation environment, fire-safety codes, load profile, and maintenance setup all push the choice in different directions. Find the scenario closest to your project below.

Industrial plant with electrical distribution infrastructure
01 / Industrial

Industrial Plant

Stable distribution for production lines, motor loads, and HVAC. Type depends on indoor or outdoor placement and fire codes.

Recommended Oil-Immersed or Dry-Type

Modern commercial office tower with glass facade
02 / Commercial

Commercial Building

Offices, malls, and hotels go with dry-type units in electrical rooms. Low noise, fire safety, and compact footprint matter most.

Recommended Dry-Type Transformer

Data center server racks with cool ambient lighting
03 / Data Center

Data Center

Servers, UPS, and cooling demand continuous, clean, low-interference power. Spec around harmonic tolerance and 24/7 uptime.

Recommended Dry-Type / Isolation / K-Rated

Open-pit mining site with heavy equipment and outdoor power infrastructure
04 / Mining

Mining & Heavy Industry

Harsh outdoor sites with dust, vibration, and heavy motor loads. Oil-immersed handles cooling demand and short-term overload best.

Recommended Oil-Immersed Transformer

Outdoor utility substation with high-voltage transformers
05 / Utility

Utility & Outdoor Substation

Grid-tied substations need continuous operation, environmental tolerance, and medium-to-large capacity for stable infrastructure.

Recommended Oil-Immersed Transformer

Utility-scale solar PV farm with battery energy storage system
06 / Renewable

Solar PV & BESS

Step-up units push inverter output onto the medium-voltage grid. Design for harmonic loads and long-term outdoor stability.

Recommended Oil-Immersed Step-Up

Step 02 Complete

Application Confirmed. Now Size the Unit.

With your application locked in, the next call is capacity and load — the spec where most projects make their first costly mistake. Send your project details and Patrick will size it with you.

Send Project Requirements Chat with Patrick

Reply within 24 hours · NDA on request

03 / Capacity

Capacity Selection

Match the unit to your real load profile, not just connected equipment power. Swipe or click through six steps.

01 / 06

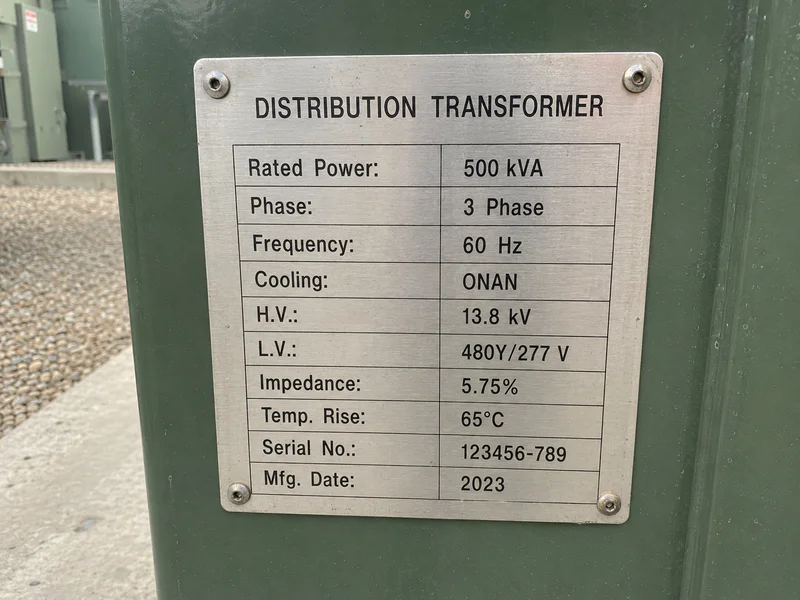

Industrial transformer with rated capacity nameplate
Part 01 / Foundation

What Does Transformer Capacity Mean?

Transformer capacity is the maximum electrical load a transformer can safely supply under specified operating conditions. It's expressed in two units:

kVA

Kilovolt-ampere. Distribution and commercial transformers.

MVA

Megavolt-ampere. Utility and large power transformers.

Most industrial and commercial distribution units run in kVA. Utility-scale power transformers run in MVA.

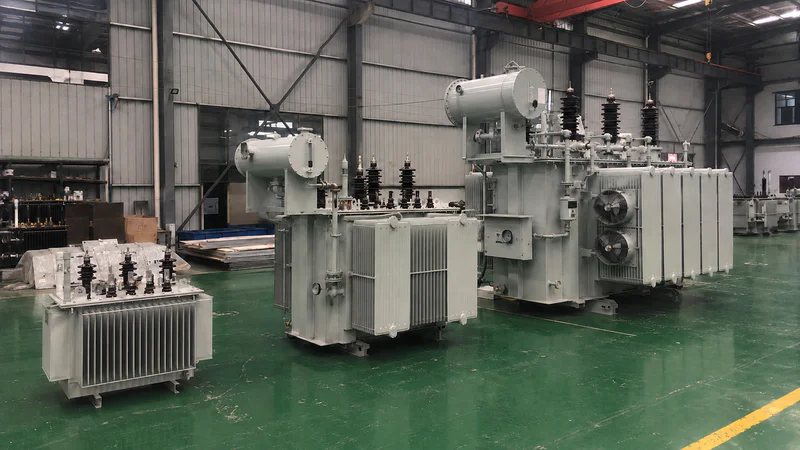

Distribution substation showing range of transformer capacities
Part 02 / Sizing Range

Typical Capacity Range by Application

Typical transformer capacity ranges by application type
Small commercial building 50 – 250 kVA
Office / retail building 250 – 1000 kVA
Industrial plant 500 – 5000 kVA
Data center 1000 – 10000+ kVA
Solar / BESS step-up 1000 – 8000+ kVA
Utility substation 2500 – 31500+ kVA

Actual capacity depends on load profile, motor starting current, operating pattern, and expansion plans.

Engineer analyzing electrical distribution load profile
Part 03 / Method

How Capacity Is Determined

Capacity isn't just an equipment count. Engineers weigh five factors before settling on a number:

  1. 01

    Total Connected Load

    Sum of motors, HVAC, lighting, production, UPS systems.

  2. 02

    Actual Operating Load

    Diversity factor matters — equipment rarely runs at peak together.

  3. 03

    Motor Starting Current

    Large motor inrush can cause voltage drop and nuisance trips.

  4. 04

    Future Expansion

    Reserve 10 – 25% margin depending on growth plans.

  5. 05

    Continuous vs Intermittent

    Heavy-duty continuous operation needs more conservative sizing.

Overloaded electrical equipment showing common sizing failures
Part 04 / Pitfalls

Common Capacity Mistakes

These four show up on roughly 1 in 3 projects. Each one costs budget, schedule, or both.

Sizing on current load only

→ No room for expansion or production increase.

Ignoring motor starting current

→ Voltage drop, overheating, protection trips on day one.

Oversizing unnecessarily

→ Higher cost, no-load loss, larger civil footprint.

Ignoring operating environment

→ Heat, altitude, and ventilation force derating.

Electrical single-line diagram and equipment specifications
Part 05 / Checklist

Info We'll Ask From You

Send whatever you have. Partial info gets a starting recommendation; complete info gets a firm quote.

  • Total load (kW / kVA)
  • Equipment list
  • Largest motor load
  • Operating pattern
  • Power factor
  • Future expansion plan
  • Indoor or outdoor install
  • Continuous or intermittent
  • Quantity of transformers
  • Single or redundant system
Engineering team reviewing transformer specifications and load calculations
24h Reply
Part 06 / Get Help

Not Sure What Capacity You Need?

Send your load list, equipment details, or single-line diagram. Our engineering team reviews your project and recommends a capacity based on your operating conditions, motor inrush, and expansion plans.

Free engineering review · NDA on request · No commitment

04 / Voltage

Configure the Right Voltage System

Four areas to lock in before quoting: common ratios in your market, tap configuration, what info we need from you, and the mistakes to avoid.

By Application

Industry & Project Type

Common transformer voltage ratios by industry application
Industrial distribution 10 kV / 0.4 kV
Commercial building 11 kV / 0.415 kV
Utility distribution 33 kV / 0.4 kV
Solar PV step-up 0.8 kV / 33 kV
Data center 13.8 kV / 480 V
Mining project 35 kV / 690 V
By Region

Local Grid Standards

Common transformer voltage ratios by region
North America 13.8 kV / 480 V / 208 V
Europe / Middle East 11 kV / 400 V
Southeast Asia 22 kV / 400 V

Confirm your local utility standard before specifying. Two adjacent countries can run completely different ratios.

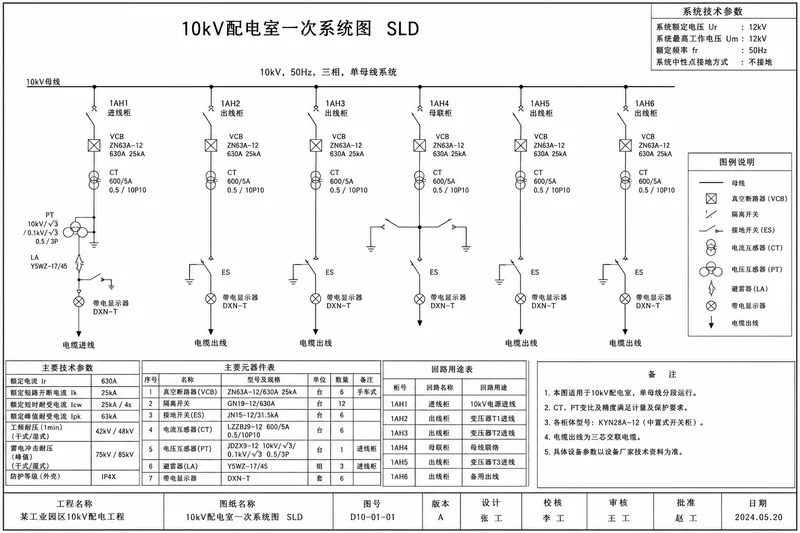

Electrical engineer reviewing single-line diagram with project specifications
24h Reply
Engineer Support

Not Sure About Your Voltage Configuration?

Send your single-line diagram, utility info, or project spec.

Patrick and the engineering team review your voltage system and recommend the right transformer configuration for your application and local market — at no cost, no commitment.

Free Engineering Review
NDA on Request
No Commitment
05 / Frequency & Phase

50Hz or 60Hz?

Frequency must match your local power system and the project's operating requirements.

Different countries run different grid frequencies. Confirming the right one before production is critical for compatibility, performance, and commissioning — get it wrong and the unit gets rejected at site.

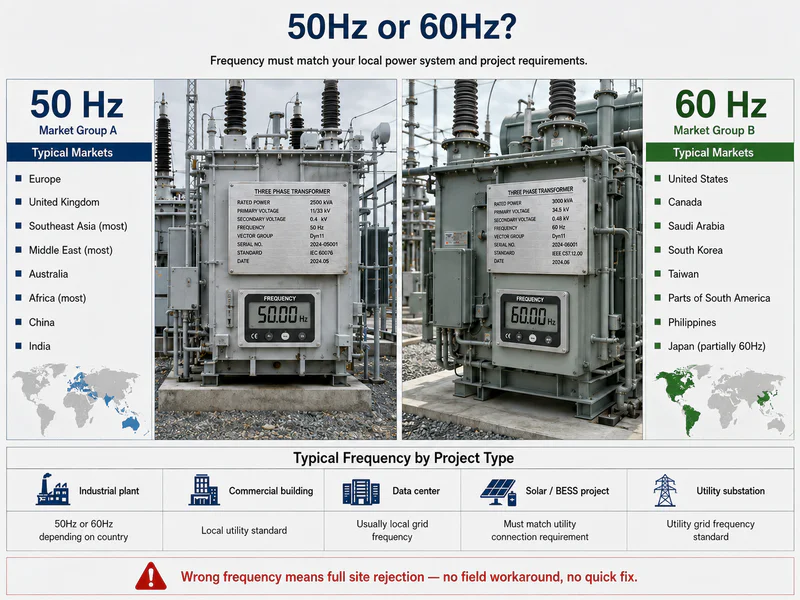

50Hz
Market Group A

50Hz Markets

  • Europe
  • United Kingdom
  • Southeast Asia (most)
  • Middle East (most)
  • Australia
  • Africa (most)
  • China
  • India
60Hz
Market Group B

60Hz Markets

  • United States
  • Canada
  • Saudi Arabia
  • South Korea
  • Taiwan
  • Parts of South America
  • Philippines
  • Japan (partially 60Hz)
Project-Type Reference

Typical Frequency by Project Type

Typical frequency requirements by project type
Project TypeCommon Frequency
Industrial plant 50Hz or 60Hz depending on country
Commercial building Local utility standard
Data center Usually local grid frequency
Solar / BESS project Must match utility connection requirement
Utility substation Utility grid frequency standard

When in doubt, ask your local utility. A 50Hz unit installed on a 60Hz grid (or vice versa) means full rejection — no field workaround, no quick fix.

Critical Confirmation

Wrong Frequency = Rejected Unit.

A 50Hz transformer on a 60Hz grid (or vice versa) means overheating, failed commissioning, and utility rejection. There's no field workaround. Confirm five details before production.

  • Project country
  • Local utility frequency
  • Equipment operating frequency
  • Utility interconnection spec
  • Existing system frequency (for retrofits)

Not Sure Which Frequency Fits?

Send your project country and we'll confirm the spec within 24 hours.

Free engineering review · 24h reply

06 / Phase

Three-Phase or Single-Phase?

Phase configuration shapes how power gets distributed across your project.

Industrial, utility, and infrastructure projects almost always run three-phase. Single-phase fits residential and small commercial loads. Swipe through the two scenarios to find your match.

Residential and small commercial single-phase power distribution
System 01

Single-Phase

Light Load

Two-wire systems carrying lighter, simpler loads. Common in homes, small shops, and basic commercial setups where load profiles stay predictable.

Best For

  • Residential buildings
  • Small commercial shops
  • Light HVAC and lighting loads
Quote a Single-Phase Unit

Industrial three-phase power distribution system at utility substation
System 02

Three-Phase

Heavy Load

Four-wire systems delivering balanced, high-capacity power. The default for industrial production, utility grids, motors, and any project where load runs continuously or at scale.

Best For

  • Industrial plants and factories
  • Utility substations and grids
  • Data centers, mining, solar & BESS
Quote a Three-Phase Unit

Wires

2-wire vs 4-wire systems

Power Capacity

Light load vs heavy load

Typical Use

Homes vs industrial sites

Side-by-Side

Compare Across 7 Configurations

Scan the row that matters most for your project. Each configuration tells you where each system fits and where it doesn't.

Row 01

Typical Application

Single-Phase

Residential and small commercial

Three-Phase

Industrial, utility, and infrastructure

Row 02

Power Capacity

Single-Phase

Lower load applications

Three-Phase

Medium and large load applications

Row 03

Common Equipment

Single-Phase

Lighting, small appliances, office loads

Three-Phase

Motors, production equipment, HVAC, heavy machinery

Row 04

Distribution System

Single-Phase

Smaller buildings and local loads

Three-Phase

Factory and large-scale distribution

Row 05

Transformer Usage

Single-Phase

Small distribution transformers

Three-Phase

Main industrial and utility transformers

Row 06

System Stability

Single-Phase

Suitable for light-duty operation

Three-Phase

Better for continuous heavy-duty operation

Row 07

Installation Scale

Single-Phase

Small-scale power distribution

Three-Phase

Large-scale power distribution

Still not sure which phase fits? Send Patrick your load list or single-line diagram and we'll confirm the spec within 24 hours.

Risk Checklist

10 Mistakes That Stall Commissioning

Frequency and phase errors are the leading cause of transformer mismatch on export projects.

Most aren't caught until site installation or utility inspection — when fixes get expensive. Scan the list, click any row to read the impact, and use it as a pre-RFQ checklist.

01

Configuration Basics

4 items
01

Assuming all countries use the same frequency

Some markets run 50Hz, others 60Hz. Wrong frequency means overheating, unstable operation, increased losses, and likely utility rejection at commissioning.

02

Confirming voltage but ignoring frequency

Voltage ratio alone isn't enough. Even with matching voltage, the unit still needs to match grid frequency and your equipment operating spec.

03

Using single-phase for industrial motor loads

Industrial equipment, production lines, pumps, and large HVAC systems need three-phase. Wrong phase config triggers unstable motor operation or full incompatibility.

04

Assuming all equipment uses three-phase

Some commercial, lighting, or auxiliary systems still need single-phase distribution even inside a three-phase project. Review load distribution during system planning.

02

Site & External Requirements

3 items
05

Not confirming utility requirements early

Utilities often require specific phase configurations, grounding methods, or connection standards for grid approval. Confirm before production starts, not after.

06

Ignoring the existing site power system

For retrofits and expansions, the new unit must match the existing distribution system. A mismatch creates installation and commissioning headaches you'll pay to fix on site.

07

Not verifying imported equipment requirements

Imported industrial equipment may use a different frequency or phase standard than your local utility. Cross-check the transformer spec with the equipment supplier before locking in.

03

RFQ Process & Planning

3 items
08

Not confirming backup power compatibility

Projects using generators, UPS, or energy storage need the transformer to be compatible with the backup system. Verify before quoting, not after the diesel arrives on site.

09

Ignoring future expansion needs

Future production lines or new equipment may need different phase distribution or extra capacity. Build expansion margin into your transformer selection now — it's far cheaper than replacing later.

10

Finalizing the RFQ without a single-line diagram

Most frequency, phase, and connection issues only surface after engineers review the single-line diagram. Without it, we're guessing at your real spec.

Send your diagram early. It cuts quotation revisions by ~70% and prevents almost all of the mistakes above.

Frequency, phase, voltage, load type, and utility requirements should all be confirmed together before transformer selection and quotation.

Lock It In Before You Quote

Confirm Phase & Frequency Together.

Voltage alone won't save you. Frequency, phase configuration, and utility requirements must be locked in together — before production starts, not after the unit arrives at site.

  • Grid frequency (50 / 60Hz)
  • Single-phase or three-phase
  • Utility connection spec
  • Equipment operating spec
  • Single-line diagram (single biggest revision-cutter)

Let Patrick Review Your Spec

Send what you have. Patrick replies within 24 hours with confirmation or flags before you commit.

Free engineering review · 24h reply · NDA on request

07 / Site

Installation Environment

Your installation conditions directly shape transformer type, cooling, protection, and long-term reliability.

Confirm site conditions before selection — it's the cheapest way to avoid overheating, premature aging, corrosion, and on-site installation surprises.

Outdoor oil-immersed transformer at industrial substation Outdoor

Outdoor Installation

Substations, mining sites, factories, and utility distribution. Built for weather, dust, UV, and harsh environmental loads.

Typical Spec

  • Oil-immersed transformer
  • IP54+ enclosure rating
  • UV-rated bushings and seals
  • Oil containment for fire safety
Indoor dry-type transformer installed in modern electrical room Indoor

Indoor Electrical Room

Commercial buildings, hospitals, data centers, and hotels. Quiet operation, low fire risk, and clean integration into occupied spaces.

Typical Spec

  • Dry-type transformer
  • Low-noise design (≤ 65 dB)
  • Compact footprint
  • No oil — safer for occupied buildings

Outdoor or indoor only tells you the broad direction. The exact spec depends on ambient conditions, codes, and operational requirements below.

Site Deep Dive

What Site Conditions Change Your Spec

Three lenses to evaluate your site: the factors driving design choices, the typical solution per environment, and the mistakes that derail commissioning.

10 Driving Factors

What Drives Your Transformer Design

Common installation factors and their impact on transformer design
Installation Factor Why It Matters
Indoor or Outdoor Determines transformer type, enclosure rating, and cooling method.
Ambient Temperature High temperature forces derating or additional cooling capacity.
Humidity & Moisture Affects insulation performance and long-term reliability.
Dust or Corrosive Air Requires higher IP rating and anti-corrosion coatings.
Ventilation Poor ventilation causes overheating and premature insulation aging.
Installation Space Drives unit dimensions, clearances, and maintenance access.
Noise Requirement Critical for hospitals, hotels, offices, and residential-adjacent sites.
Fire Safety Often the deciding factor between oil-immersed and dry-type.
Altitude Above 1,000m, cooling and insulation need adjustment.
Local Code & Utility Some markets enforce specific clearances or protection classes.
Pre-Quote Site Brief

Site Details We'll Confirm With You.

Nine site conditions shape your transformer spec. Send what you know — partial info gets a starting recommendation, complete info gets a firm quote on the first round.

  • Indoor or outdoor
  • Ambient temperature
  • Altitude
  • Ventilation condition
  • Space limitations
  • Noise requirement
  • Fire safety codes
  • Dust, humidity, corrosion
  • Local code & utility

Discuss Your Installation Conditions

Share your site details and Patrick recommends the right configuration within 24 hours.

Free engineering review · 24h reply

08 / Load

Load Characteristics

Match the transformer to your real load behavior, not just rated capacity.

Different load profiles change sizing, temperature rise, voltage stability, and long-term reliability. Get the load wrong and the spec on paper won't survive first-year operation.

Industrial motor load at production facility
Motor Load

Production lines, pumps, compressors

Data center continuous load with 24/7 operation
Continuous Load

Data centers, utility systems

UPS and variable frequency drive systems generating harmonic load
Harmonic Load

UPS, VFD, server systems

Heavy industrial load at mining or manufacturing facility
Heavy Industrial

Mining, manufacturing plants

Solar PV farm and battery energy storage system
Renewable

Solar PV, BESS, grid feed-in

Mixed commercial building load profile
Mixed Commercial

Buildings, hotels, retail

6 Load Profiles

Find Your Match

Load types matched to typical projects and key selection considerations
Load TypeTypical ProjectSelection Consideration
Motor

Factory, pumps, compressors

High starting current, voltage fluctuation

Continuous

Data center, utility system

Stable operation, long-term efficiency

Harmonic

UPS, VFD, server systems

Harmonic tolerance, thermal performance

Heavy Industrial

Mining, manufacturing

High reliability, overload capability

Renewable

Solar PV, BESS

Grid connection, inverter compatibility

Mixed Commercial

Building, hotel, retail

Stable distribution, low-noise operation

Load Profile Review

Mixed Loads Need a Real Engineer.

Most real projects don't fit one clean category. Motor inrush stacks on harmonic loads, renewables sit alongside legacy equipment. Let Patrick map your actual profile to the right design — not a textbook match.

  • Equipment list & duty cycle
  • Largest motor / starting current
  • VFD, UPS, or inverter content
  • Peak vs continuous demand
  • Power factor & expected harmonics

Send Your Load List

Equipment list or single-line diagram works best. Patrick maps your real load profile within 24 hours.

Free engineering review · 24h reply

09 / Efficiency

Efficiency & Loss

Efficiency drives long-term operating cost, energy consumption, and thermal performance.

For utility, industrial, and 24/7 projects, low-loss design isn't a luxury — it pays back in energy savings and reliability over the unit's 20+ year service life.

2 Sides

No-Load + Load

Two loss types determine your total energy bill over service life.

≥98%

Modern Efficiency

Premium designs hit 98%+ — every extra point compounds over 20 years.

≤ 65 dB

Low Noise

Critical for hospitals, hotels, offices, and residential-adjacent sites.

6 Performance Factors

What Drives Efficiency & Loss

Key efficiency factors and why they matter for transformer selection
Key Factor Why It Matters
No-Load Loss Energy consumed even when the transformer isn't heavily loaded. Runs 24/7 regardless of demand.
Load Loss Increases with operating load. Compounds over years into a serious operating cost line item.
Overall Efficiency Critical for continuously operating systems and utility applications where energy bills are large.
Temperature Rise Excessive heat shortens insulation life and reduces reliability. Direct link to service lifespan.
Noise Level Often the deal-breaker for indoor commercial sites — hospitals, hotels, offices, and residential-adjacent.
Cooling Performance Determines stability under heavy-duty operation, high ambient temperature, and overload conditions.
Pre-Selection Checklist

Confirm Before Picking Your Design

  • Operating load profile
  • Continuous or intermittent
  • Ambient temperature
  • Energy efficiency target
  • Noise limitation
  • Local efficiency standard
Bottom Line

Right Design = Lower Lifetime Cost

A 1% efficiency improvement on a 2000 kVA unit running 24/7 saves roughly $4,000-6,000 in energy per year. Across a 20-year service life, the right design pays for the unit twice over.

10 / Standards

Standards, Testing & Compliance

Different projects and markets need different standards, test protocols, and compliance documents.

Confirm them early and you cut approval delays, technical mismatch, and production rework — the three biggest schedule killers on export projects.

01 / Standards

International & Local Standards

We build to IEC for international and utility projects, ANSI/IEEE for North America, and adapt to specific utility requirements wherever your project lives.

We Work With

IEC · ANSI · IEEE · Local Utility Specs

02 / Testing

Full Factory Test Coverage

Routine tests run on every unit before shipment. Type tests and customer-witnessed FAT available for specific designs and high-spec projects.

Test Scope

Routine · Type · FAT · 3rd-Party Witnessing

03 / Compliance

Project-Ready Documentation

Test reports, drawings, nameplate specs, MSDS, and country-specific certificates — all delivered in the format your customs and utility approval need.

Deliverables

Test Reports · Drawings · CoC · Country Certs

What to Confirm Early

6 Items to Lock In Before Production

  • Destination market requirement
  • Utility or EPC spec
  • Required testing scope
  • Third-party inspection
  • Local compliance docs
  • Project approval process
Country Certifications

Need Market-Specific Certs?

SABER, KEBS, SONCAP, INMETRO, KC, BSMI, CE — we've shipped to most of them. Browse our country-by-country compliance library, or just send your destination and we'll confirm.

Confirm My Market Requirements
11 / Protection

Protection & Accessories

Accessories aren't optional add-ons — they shape operational safety, voltage stability, and 20-year reliability.

The right configuration depends on your installation environment, operating profile, and utility requirements. Pick your project below and we'll show you what we'd typically build in.

Step 1

Choose Your Project Type

Step 2

Recommended Configuration

01
Utility · Substation

High-Reliability Grid Service

Must Have

  • Protection Relay
  • On-Load Tap Changer (OLTC)
  • Buchholz Relay
  • Temperature Monitoring

Recommended

  • Surge Protection
  • Pressure Relief Device
  • Remote Fault Monitoring

Engineering Note: Utility approval almost always requires specific relay configurations and protection coordination studies. Confirm utility spec before locking in the design.

Quick Reference

10 Accessories at a Glance

Click any category for details. All accessories are spec'd to project needs, not bolted on by default.

Voltage Control

Tap Changer

Adjusts output voltage under different operating conditions. OLTC for live switching, off-circuit for periodic adjustment.

Thermal Monitoring

Temperature Monitor

Monitors oil or winding temperature in real time. Triggers alarms before overheating damages insulation.

Internal Safety

Pressure Relief Device

Releases abnormal internal pressure before catastrophic failure. Critical for oil-immersed designs.

Fault Detection

Buchholz Relay

Detects internal gas accumulation from insulation breakdown or arcing — early warning for oil-immersed faults.

Cooling System

Cooling Fan

Forced-air cooling for sustained heavy-load operation. Auto-activates when temperature crosses set threshold.

Oil Condition

Oil Level Indicator

Tracks oil level and condition for early leak detection and maintenance planning.

Surge Protection

Lightning Arrester

Diverts lightning strikes and switching surges to ground, protecting windings from voltage spikes.

Electrical Safety

Protection Relay

Overload, short-circuit, and fault protection. The transformer's electrical brain — coordinates with utility protection scheme.

Physical Protection

IP Enclosure

Sealed enclosure protecting against dust, moisture, and weather. Rating (IP31 / IP54 / IP65) chosen by site conditions.

Environment Resistance

Anti-Corrosion Coating

Heavy-duty multi-layer coating for coastal, humid, or chemical-aggressive environments. Triples service life in harsh conditions.

Step 3

8 Items We'll Confirm With You

  • Indoor or outdoor
  • Utility protection spec
  • Operating temperature
  • Cooling requirement
  • Monitoring level
  • Surge / lightning risk
  • Maintenance preference
  • Environmental conditions

We don't over-spec by default. The right configuration matches your actual project — not a checklist of every available accessory.

Custom Configuration

Want a Configuration Built for Your Project?

Send your project type, site conditions, and any utility requirements. Patrick comes back with a recommended accessory list and a transparent breakdown of what each item does — no over-selling.

12 / Selection

Quick Selection Guide

Five steps to narrow your spec from broad project type to a buildable configuration.

Walk through each step, gather what you have, and bring the partial picture to us. We finalize the rest together.

01
Step 1

Installation Environment

Where Will It Live?

Outdoor and industrial environments favor oil-immersed designs for cooling and weather resistance. Indoor sites — commercial buildings, hospitals, data centers — prefer dry-type for fire safety and quiet operation.

Key Decisions

Indoor / Outdoor Industrial / Commercial Ventilation Fire Safety Code

Determines core transformer type (oil-immersed vs dry-type) and enclosure rating.

1 / 5
Confirm installation environment for transformer selection Step 01
Evaluate load characteristics across different project types Step 02
Review operating conditions including temperature humidity and altitude Step 03
Confirm standards testing and project compliance documents Step 04
Finalize transformer configuration with voltage capacity and protection Step 05

Worked through the steps? Send what you have and we'll confirm the recommended direction.

13 / Mistakes

Selection Mistakes We See Every Week

Most transformer problems aren't manufacturing defects — they're selection decisions made with incomplete project information.

Ten patterns we see repeatedly on industrial, utility, and export projects. Read it as a pre-RFQ checklist, not a list of blame.

Project Risk Checklist

10 Patterns That Cause Rework

  • 01

    Confirming transformer type too late

    Oil-immersed and dry-type need completely different installation conditions and protection design. Switching late costs redesign cycles.

  • 02

    Sizing only on current load

    Future expansion, motor starting current, and continuous operation get overlooked. Capacity should match real demand profile, not rated nameplate today.

  • 03

    Ignoring local voltage and frequency

    Equipment incompatibility or failed commissioning. There's no field workaround once the unit ships.

  • 04

    Skipping utility or EPC spec confirmation

    Grid approval, testing requirements, or installation clearances surface late — typically during pre-commissioning, when fixes are expensive.

  • 05

    Underestimating installation environment

    Temperature, humidity, dust, or altitude impact cooling and insulation life. A spec built for "standard conditions" fails fast in real-world sites.

  • 06

    Ignoring harmonic or motor load characteristics

    Voltage instability, overheating, or protection trips appear during first-year operation. Hard to retrofit harmonic tolerance after the fact.

  • 07

    Locking standards & testing late

    Redesign, delayed production, or project approval blockers. Standards drive too many design decisions to leave open-ended.

  • 08

    Skipping the existing system review

    Retrofit and expansion projects need to match existing distribution. Mismatch creates site installation and commissioning headaches.

  • 09

    Missing protection or monitoring requirements

    Operational risk and harder maintenance over the unit's 20-year service life. Adding monitoring after install costs 5-10× the original spec.

  • 10

    Sending incomplete RFQ information

    Multiple quotation revisions and longer lead time. The biggest single cause of project delays — and the easiest to fix.

Most of these are prevented by confirming requirements early and reviewing the electrical system before quotation. The cheapest engineering hours are the ones spent before production.

14 / RFQ

RFQ Preparation

You don't need a complete technical file to talk to us.

Send the basics you already have. Our engineering team confirms the missing pieces — transformer type, voltage, capacity, protection — and comes back with a recommendation, not a blank quote form.

Engineering team reviewing single-line diagram and project specifications
Engineer Support

Send what you have. We fill the gaps.

Minimum Info

5 Things to Start a Quote

  • Project country
  • Application / project type
  • Transformer type (if known)
  • Voltage requirement
  • Estimated capacity

Not sure about all the details? Send what you have — we'll help confirm the missing information.

If Available

Optional — Helps Us Recommend Faster

Single-line diagram Equipment list Existing transformer spec Project drawings Utility requirement

Free engineering review · 24h reply · NDA on request

15 / FAQ

Frequently Asked Questions

Real questions from industrial, utility, and export project teams.

If yours isn't here, send it to Patrick directly — we'll add it.

01

Selection

How do I know whether I need an oil-immersed or dry-type transformer?

Selection depends on installation environment, fire-safety requirements, operating conditions, and project capacity.

Oil-immersed transformers fit outdoor, utility, and high-capacity applications. Dry-type fits indoor sites — commercial buildings, hospitals, data centers — where fire safety and low noise matter.

02

Process

What information is required before requesting a quotation?

Most important: project country, transformer type, voltage requirement, estimated capacity, and installation environment.

If available, single-line diagrams or equipment lists significantly improve quotation accuracy and cut revision rounds.

03

Process

Can you help if the transformer specification isn't fully confirmed yet?

Yes — most projects start with incomplete information.

Our engineering team reviews your project application, load condition, and distribution system, then recommends a transformer configuration. Send what you have.

04

Selection

What's the difference between distribution and power transformers?

Distribution transformers handle medium-to-low voltage power distribution in factories, buildings, and local utility systems.

Power transformers handle higher-voltage transmission and utility substations — larger capacity, more complex grid requirements.

05

Customization

Can the transformer be customized for local utility requirements?

Yes. Voltage ratio, frequency, vector group, protection configuration, enclosure type, and testing requirements can all be configured to match your project specification and local utility requirements.

06

Testing

What testing is usually performed before shipment?

Routine factory testing runs on every unit before shipment to verify electrical performance and operating condition.

Additional type testing, FAT (Factory Acceptance Test), or third-party inspection (SGS, BV, TÜV) can be arranged for high-spec projects.

07

Environment

Can transformers handle high-temperature, coastal, or high-altitude environments?

Yes, but the design typically needs adjustment.

Cooling configuration, enclosure protection, anti-corrosion treatment, and insulation design are commonly reviewed and adapted for harsh environments.

08

Process

Why do utility and EPC projects require so many technical confirmations?

Transformer projects connect tightly to local grid, protection system, and site operating conditions.

Confirming voltage, frequency, protection, and testing requirements upfront cuts commissioning issues and project delays significantly downstream.

09

Selection

Can the configuration be adjusted for future expansion?

Yes. Many industrial and infrastructure projects reserve additional capacity or flexible configuration for future load expansion and system upgrades. We help size the expansion margin during quotation.

10

Compliance

Do different countries use different transformer standards?

Yes. Different markets use different voltage systems, frequencies, testing procedures, and compliance requirements.

For export projects, always confirm local standards and utility requirements before production starts.

11

Selection

Can existing transformers be replaced without changing the whole distribution system?

In most retrofit projects, the new transformer can be configured to match the existing voltage system and installation conditions.

The existing distribution layout and utility requirements should be reviewed before replacement to confirm compatibility.

12

Process

What factors usually affect transformer lead time?

Lead time depends on transformer capacity, material availability, customization scope, testing requirements, and project-specific compliance. Standard units ship faster; high-spec custom builds with FAT and third-party inspection take longer. We confirm exact lead time per project at quotation.

16 / Contact

Discuss Your Transformer Project

Send your project information, drawings, or technical requirements.

Patrick and our engineering team review the transformer type, voltage configuration, installation environment, and project requirements — before quotation and production.

Patrick from ZOE Transformer engineering team Available Today

Patrick

ZOE Engineering

Transformer & Power Distribution Project Support

Patrick works with industrial, utility, and infrastructure transformer projects — helping customers review voltage configuration, installation conditions, and project requirements before production.

For projects with incomplete specifications, our engineering team assists with preliminary technical review and configuration confirmation.

Specialties

Industrial & Utility Oil-Immersed & Dry-Type Export Projects Technical Review
Project Inquiry

Send Your Project Information

No pre-filled spec sheets needed. Send what you have — we'll confirm the rest within 24 hours.

Supported: PDF, DWG, JPG, PNG, DOC · Max 10MB total

Project drawings and technical information are used only for quotation and engineering review.
Free engineering review · 24h reply · NDA on request
